ctcLink Reference CenterHuman Capital ManagementHR Core HR Core - 05 Job Effective Dated Row Insert (Short Work Break)

Job Effective Dated Row Insert (Short Work Break)

PURPOSE: Use this document as a reference for creating an new effective date row in Job Data for a single group of employees.

AUDIENCE: Human Resource Specialists and/or Human Resource Administrators

Navigation: Main Menu  > Workforce Administration > CTC Custom > CTC Processes > Create New Job Eff. Dated Row

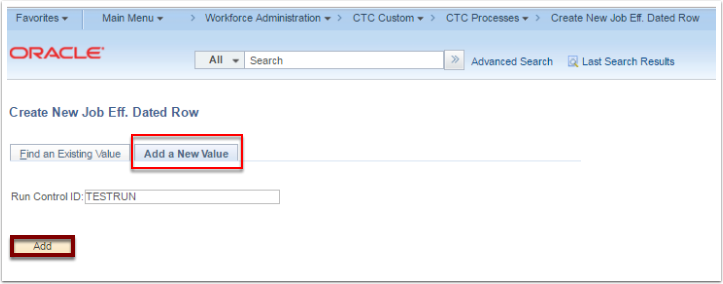

  1. Click the Add New Value tab. (This step is strictly for the first run; after that you may use this new run control).
  2. Create a Run Control (something unique and easy to remember).
  3. Click the Add button.

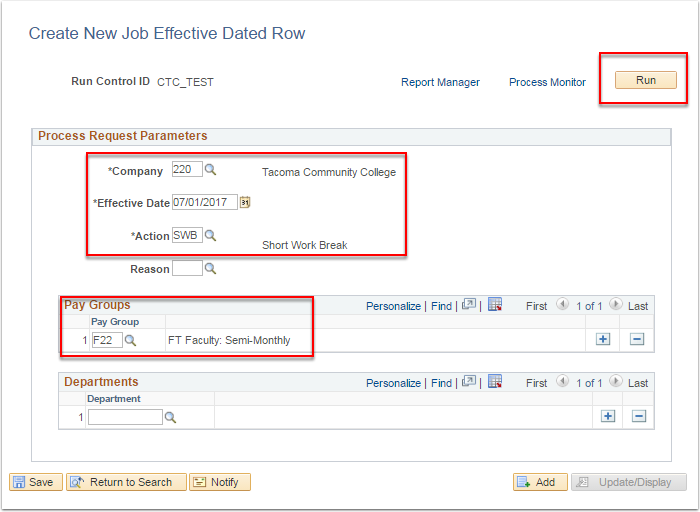

Add a New Value tab
  1. Select the appropriate Company.
  2. Enter/Select the Effective Date for the Job Data Insert.
  3. Select the appropriate Action for the Job Data Record.
  4. Select the appropriate Reason (optional but highly recommended).
  5. Select the appropriate PayGroup.
    Contract Begin  Date
    Contract End Date
  6. Select the appropriate Department (if applicable).
    Contract Begin Date
    Contract End Date

WARNING: The system WILL NOT create/insert a new row for an employee with an effective dated row that is greater than the date entered in step #6; or if the employee has an Expected Job End Date less than the effective date in step #6.

Should an employee have a future dated row greater than the effective date entered in step #6; a manual entry will need to be created Job Data.  Additionally, if an employee has an Expected Job End Date that is less than the date entered in step #6; a manual entry will need to be created in Job Data.

Be sure to check your report results for validation.

This process WILL create an effective dated sequence for multiple actions with the same effective date.

Process Request Parameters section

WARNING: The system WILL NOT generate a new effective dated row for the Return from Workbreak Action IF the Short Work Break Action is NOT the most recent previous action of record.

It may be best to run this process for both actions simultaneously (1st Run = SWB; 2nd Run = RWB)

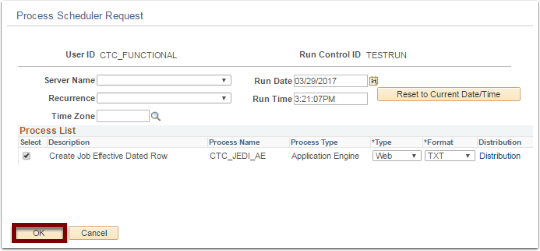

  1. Click Run, to activate the process request.
  2. Click OK.
Process List section
  1. Click the Process Monitor hyperlink to view the progress of the request.

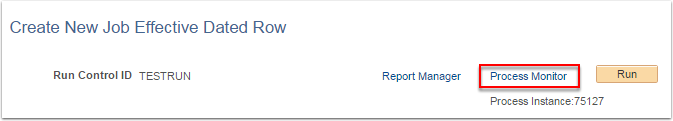

Process Monitor link
  1. Click Refresh until the Run Status changes to Success and the Distribution Status changes to Posted.

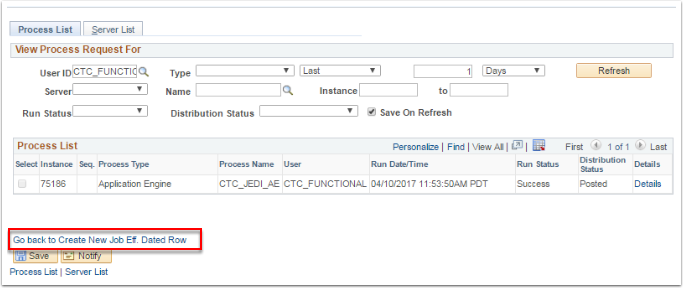

  2. Click the Go back to Create New Job Eff. Dated Row hyperlink.
Process List tab and Go back to Create New Job Eff Dated Row link

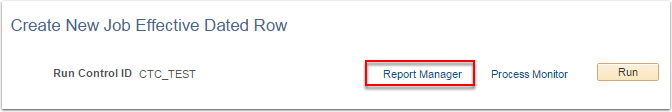

  1. Click the Report Manager hyperlink.
Report  Manager link

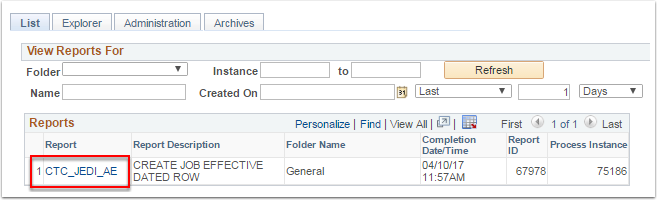

  1. Click the  CTC_JEDI_AE report link.
List tab

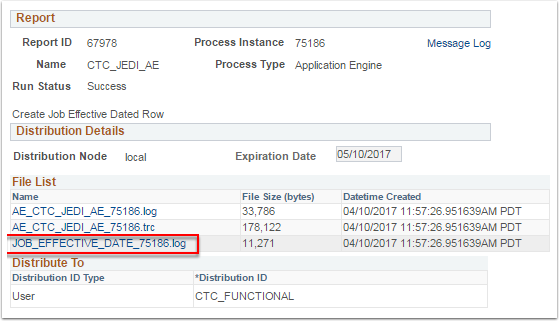

  1. Click the JOB_EFFECTIVE_DATE hyperlink to view the actual results. (A separate window will appear containing the results. It is best to save or print these results for validation).
File List section

NOTE: You should ALWAYS VALIDATE your data at the end of this process. Select a few individuals from the results list to validate in Job Data.  (Navigation: Main Menu >  Workforce Administration > Job Information > Job Data)

Remember to look for those employees with a future dated row greater than the date selected for this process. Those employees will need to be updated manually.

Congratulations you have successfully inserted an Effective Dated Row into Job Data for a single Pay Group!!!!
